Steel structure warehouse hoisting process and hoisting plan-Chapter 1

Time:[2021-9-25]  Hits:2554

Hoisting process



Positioning --- Calibration Height --- Column Top Bolt Embedded --- Calibration Height - Elastic Line - Column Installation - Steel Beam Installation - Secondary Structure Installation --- --Welding----Repainting----Completion





Steel column installation process


A,Lifting of steel columns



1.Re-test the foundation, including the exposed length of the anchor bolt, the displacement deviation of the anchor bolt center line to the reference line, the distance between the anchor bolts, and the foundation elevation. The unqualified ones can be handled before lifting.



2.In order to control the installation elevation of the column, a 500mm position is also marked on the visible cross section of the column in advance for fine-tuning and correction of the elevation during installation. Install the steel column on the basis of qualified retest, first tie the column with a single steel wire rope, and choose the position of the lifting point at a position 1/3 of the length of the column from the end of the column. The column is lifted by the rotation method, and the steel column is lifted and sent to the installation position. The lashing place should be padded.





B, the correction of the steel column



1.Draw the center line in advance on the visible surface of the column, and then use the theodolite to adjust the verticality of the column in two mutually perpendicular directions.



2.Control the verticality of the column by measuring the distance between the inner side of the column and the control line on the building.



3.The adjustment of the elevation, axis and verticality deviation of the column are related to each other, and the correction work will be completed when all the standards are met.





Steel beam installation process



Unload the steel beams to the vicinity of each column, hoist them to the floor with a car, and then install them by mast cranes. The main beams with some heavy components can be platform craned with car cranes. The secondary beam can be installed with a self-made wheeled crane (5t). Starting from the third zone, the main girder, the secondary girder and then the purlin, the steel girder shall be hoisted by masts one by one according to the number. Only when the two ends of the girder are fastened with bolts (or spot welded firmly), the hooks can be loosened and the others are hoisted in sequence Steel beams. Weld after passing the inspection.

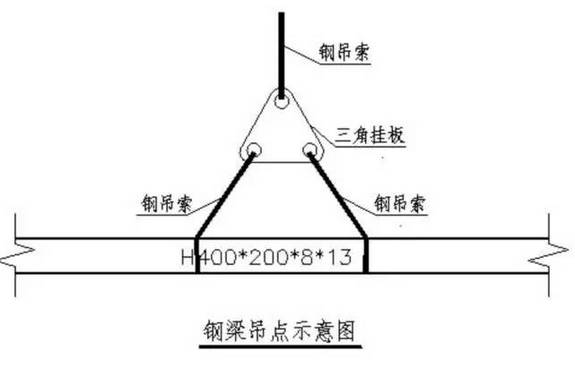

The lashing and hoisting points of steel beams are particularly important. Steel poles can be used when the steel beams are too long. There are many steel beams in this project with a maximum length of about 20m. A triangular hanging plate is used to enlarge the distance between the steel ropes to increase the angle of the steel ropes. Require. Schematic diagram of steel beam lashing.




Copyright:佛山市勝邦鋼結構有限公司 Foshan Shengbang Steel Structure Co., Ltd. Record Number:粵ICP備13078463號
主站蜘蛛池模板: 台湾佬自偷自拍情侣在线| 青青热久久久久综合精品| 亚洲韩国日本欧美一区二区三区| 一级a级毛片| 午夜精品在线视频| 日本人免费xxx在线视频| 啪视频在线观看高清| 欧美激情一区二区三区视频| 亚洲色图国产| 四虎影视在线永久免费看黄| 日本免费观看完整视频| 亚洲精品国产成人99久久 | 一级毛片特级毛片黄毛片| 亚洲性xo| 特级淫片日本高清视频| 三级黄色片免费| 午夜亚洲国产| 亚洲精品亚洲人成毛片不卡| 一二三区乱码一区二区三区码| 深夜一级毛片| 日产国产精品久久久久久| 人人玩人人玩| 日本a网站| 欧美男女激情视频| 日韩亚洲欧美在线观看| 亚洲精品aaa| 日韩欧美激情| 色网站在线看| 日韩精品视频美在线精品视频 | 人人搞人人| 日本二本道| 一本久| 日本免费观看完整视频| 日产免费线路一区二区三区| 欧美日韩一| 三级网站在线| 夜间福利影院| 欧美成人性色xxxx视频| 色婷婷狠狠久久综合五月| 午夜国产精品久久久久| 亚洲天堂网2014|
